Quick Answer

How Much Does Salesforce Implementation Cost? (Quick Answer)

Salesforce implementation typically costs between $10,000 and $500,000+ in 2026. Small businesses with a standard Sales Cloud setup usually spend $10,000–$30,000. Growing businesses spend $30,000–$100,000, mid-market companies $75,000–$250,000, and enterprise or multi-cloud programs $150,000–$500,000 or more. These figures cover implementation services only. Salesforce licenses are a separate, recurring per-user cost.

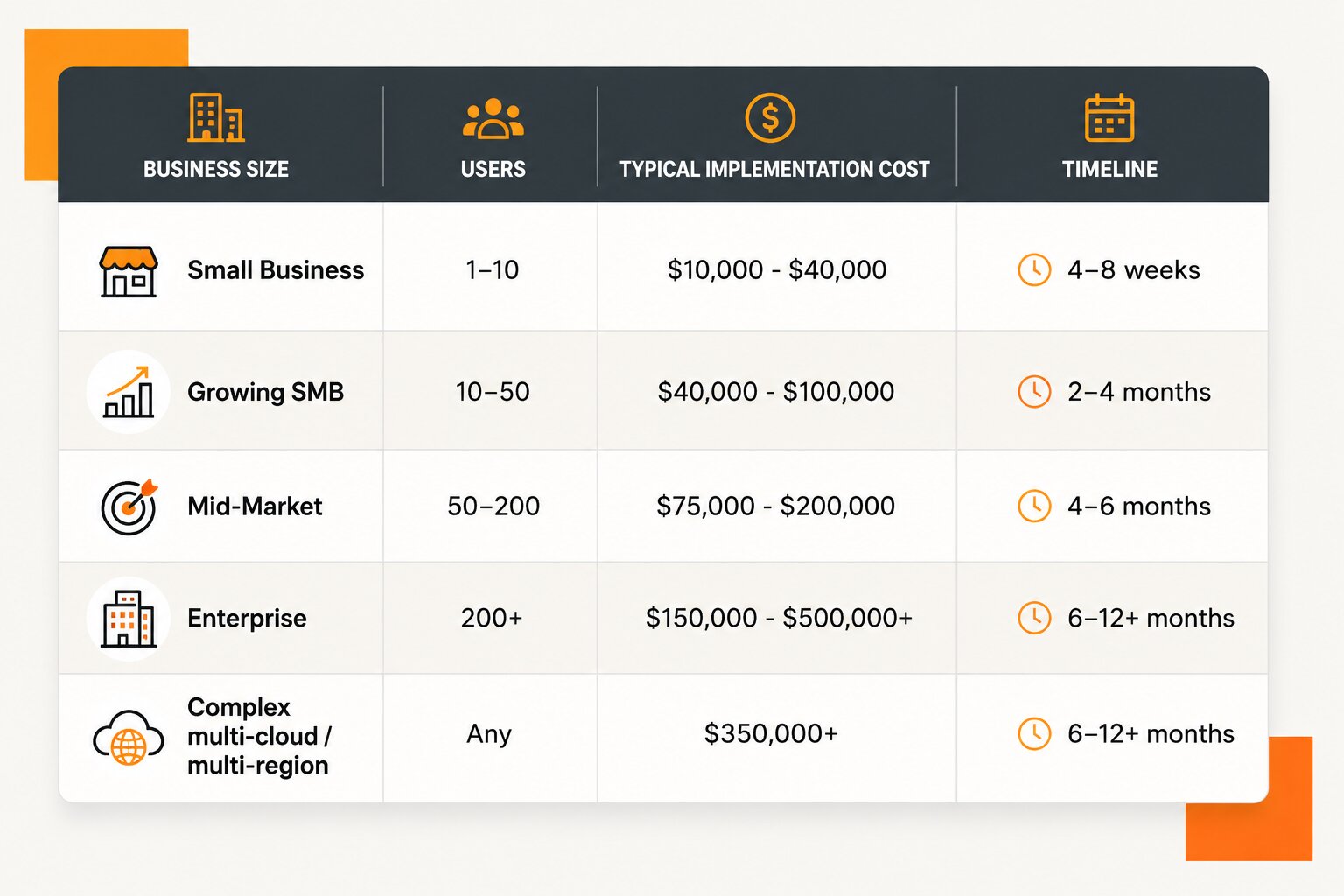

Business Size Typical Users Implementation Cost Typical Timeline Common Scope
Small business Up to 20
$10,000–$30,000
4–8 weeks Standard Sales Cloud setup, basic automation, simple data import
Growing business 20–75
$30,000–$100,000
2–4 months Custom workflows, one or two integrations, structured training
Mid-market 75–250
$75,000–$250,000
3–6 months Multiple clouds, ERP or marketing integrations, larger data migration
Enterprise 250+
$150,000–$500,000+
6–12+ months Multi-cloud architecture, complex integrations, governance, phased rollout

What moves your cost up or down most

↕Number of integrations↕Volume and quality of data you migrate↕Custom development needed↕Number of Salesforce products deployed

✦ Key Takeaways

→

Scope drives cost more than company size. A 50-user company with a custom ERP integration can spend more than a 200-user company using standard features.

→

Licenses are separate. Implementation is mostly a one-time services cost; licenses are a recurring subscription.

→

The first quote is rarely the full cost. Budget for data cleanup, third-party apps, training, and post-launch support.

→

Agentforce and Data Cloud add new cost lines. AI and data projects need their own design, setup, and consumption planning.

→

Compare quotes on scope, not price. A lower quote often leaves out work you’ll pay for later.

Free Cost Estimate

Want a number for your project?

Worxwide’s Salesforce consultants can review your requirements and give you a scoped implementation estimate, free.

Get Your Free Cost Estimate →

Ask three Salesforce partners to quote the same project and you may get three very different numbers.

One says
$40,000
Another says
$95,000
The third
Won’t give a figure until after a discovery workshop

That spread doesn’t mean someone is guessing. It reflects how much the final cost depends on what sits underneath the license: your data, your integrations, your processes, and how much needs to be built versus configured.

This guide helps you build a realistic budget before you talk to vendors, and judge their quotes once you do. Below, you’ll find:

✓Costs by Salesforce product and project phase✓Hidden costs most quotes leave out✓First-year and three-year TCO example✓Checklist for comparing implementation partners

Cost Components

What Does Salesforce Implementation Cost Include?

Salesforce implementation cost covers the professional services needed to make Salesforce work for your business: discovery, configuration, customization, data migration, integrations, testing, training, and go-live support. It does not include Salesforce license fees, which you pay to Salesforce separately.

01

Discovery and planning

Requirements, process mapping, solution design, project plan

02

Configuration

Objects, fields, page layouts, permissions, reports, dashboards

03

Customization

Flow automation, Apex, Lightning Web Components, custom apps

04

Data migration

Extraction, cleanup, deduplication, mapping, import, validation

05

Integrations

Connecting Salesforce to ERP, marketing, finance, or other systems

06

Testing

Functional testing, integration testing, user acceptance testing (UAT)

07

Training and adoption

Admin and end-user training, documentation, change management

08

Go-live and hypercare

Production deployment and stabilization support after launch

✦ Quote check: when comparing quotes, check that each of these eight lines is included. Missing lines usually show up later as change requests.

Know the Difference

Salesforce License Cost vs. Implementation Cost

Licenses
Give you access to Salesforce
A recurring subscription billed per user.
vs
Implementation
Makes it fit your business
Mostly a one-time services cost, followed by ongoing support.
Cost Type What You Pay For Payment Pattern
Salesforce licenses Editions, users, and add-on products Recurring, usually annual
Implementation services Setup, customization, migration, integrations, testing Mostly one-time
Third-party tools AppExchange apps, middleware, backup tools Usually recurring
Ongoing support Administration, enhancements, managed services Recurring

License Pricing

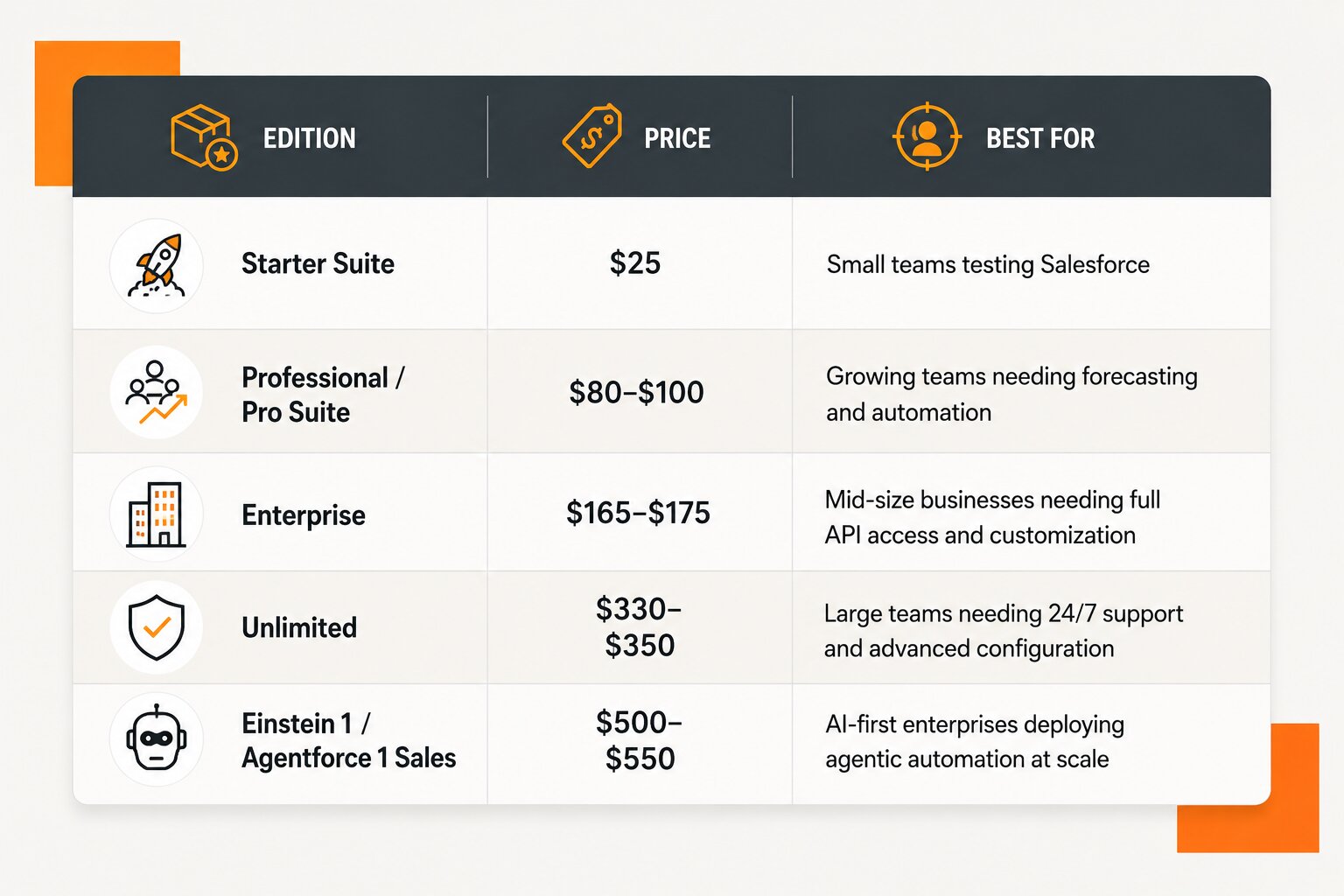

Salesforce Sales Cloud Pricing in 2026

For budgeting, here are Salesforce’s published list prices for Sales Cloud editions (per user, per month, billed annually):

Starter Suite

$25/user/mo
Small teams that need core CRM features

Pro Suite

$100/user/mo
Growing teams that need automation and forecasting

Enterprise

$175/user/mo
Mid-size and larger companies that need customization and API access

Unlimited

$350/user/mo
Large teams that need advanced features and expanded support

Agentforce 1 Sales

$550/user/mo
Organizations adopting AI agents and Data Cloud at scale

Prices are Salesforce list prices at the time of writing and change periodically. Check Salesforce’s official pricing page for current rates. Enterprise agreements and multi-year contracts are often discounted.

Same Edition, Different Budget

Two companies on the same edition can still have very different implementation budgets. One may need a basic setup and a single data import. Another may need ERP integration, complex automation, and migration from several legacy systems. That’s why estimating implementation cost from license count alone usually produces an unrealistic budget.

Cost by Phase

How Is Salesforce Implementation Cost Split Across Project Phases?

In a typical project, configuration and customization take the largest share of the budget (around 35–45%), followed by integrations and data migration. Discovery, testing, training, and go-live make up the rest. The exact split shifts with your scope: integration-heavy projects spend more on integrations, while projects moving messy legacy data spend more on migration.

Phase Typical Share of Budget Example: $60,000 Project What Drives the Cost
Discovery and design 10–15%
~$7,000
Number of teams, processes, and stakeholders
Configuration and customization
Largest share
35–45%
~$24,000
Custom objects, Flow automation, Apex, UI work
Data migration 10–20%
~$8,000
Data volume, number of source systems, data quality
Integrations 10–25%
~$9,000
Number of systems, real-time vs. batch, middleware
Testing and UAT 10–15%
~$6,000
Process complexity, integration testing, user availability
Training and change management 5–10%
~$3,000
Number of users, roles, and locations
Go-live and hypercare 5–10%
~$3,000
Cutover complexity, length of post-launch support

Where Budgets Usually Go Wrong

Most overruns come from three phases.

⚠ Overrun Risk 1

Discovery that’s too short

When requirements aren’t fully mapped upfront, the gaps show up during build as change requests. Spending a little more on discovery usually saves far more later.

⚠ Overrun Risk 2

Data that’s messier than expected

Duplicate records, inconsistent formats, and missing fields often surface only once migration starts. Cleaning data inside Salesforce after go-live costs more than cleaning it before.

⚠ Overrun Risk 3

Integrations that grow in scope

A “simple” ERP connection can turn into bi-directional sync, error handling, and middleware setup. Define each integration’s direction, frequency, and data objects during discovery.

✦ Budgeting Tip

If a quote puts less than 10% into discovery or testing on a complex project, ask why. Underfunding these phases is one of the most common reasons projects run late and over budget.

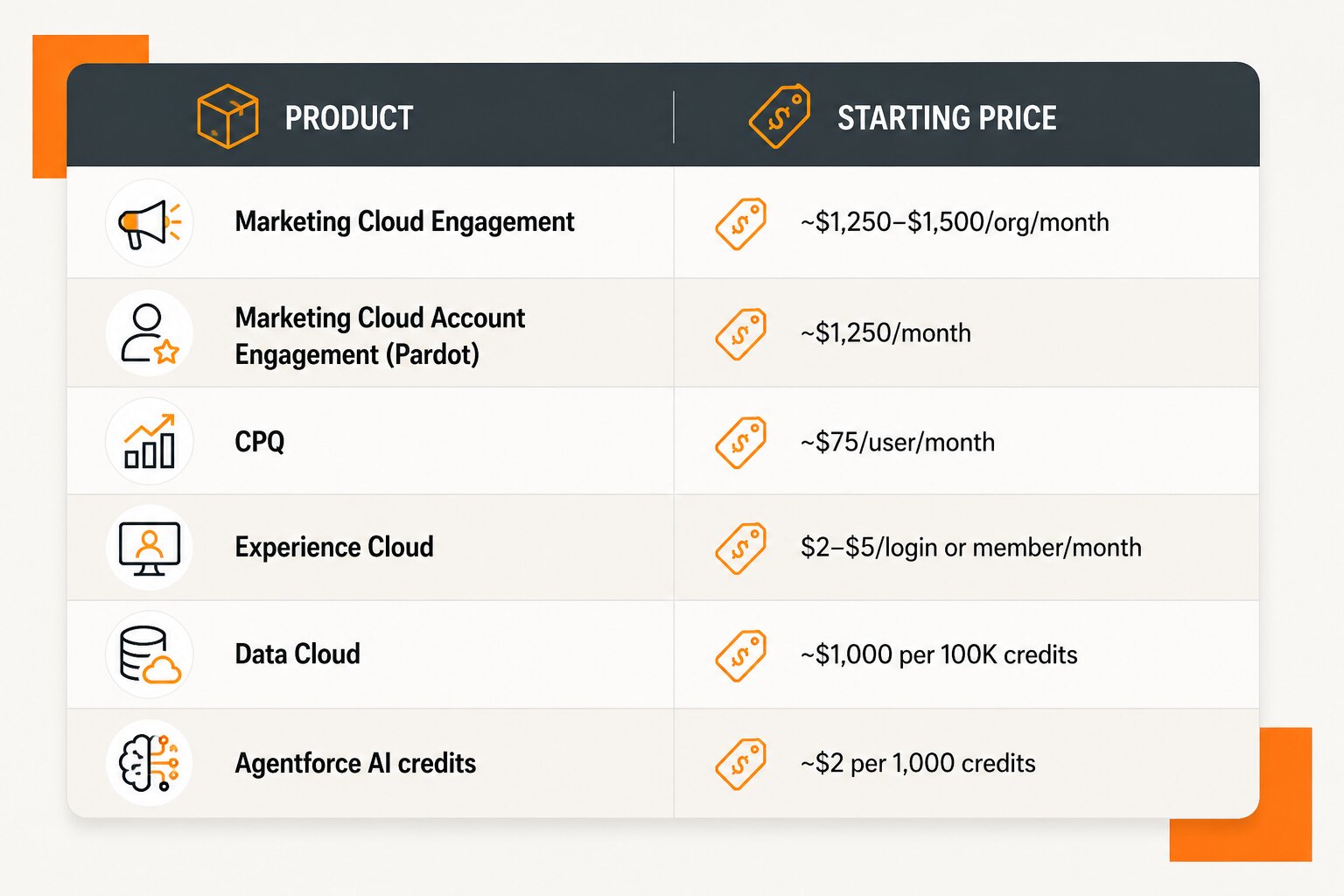

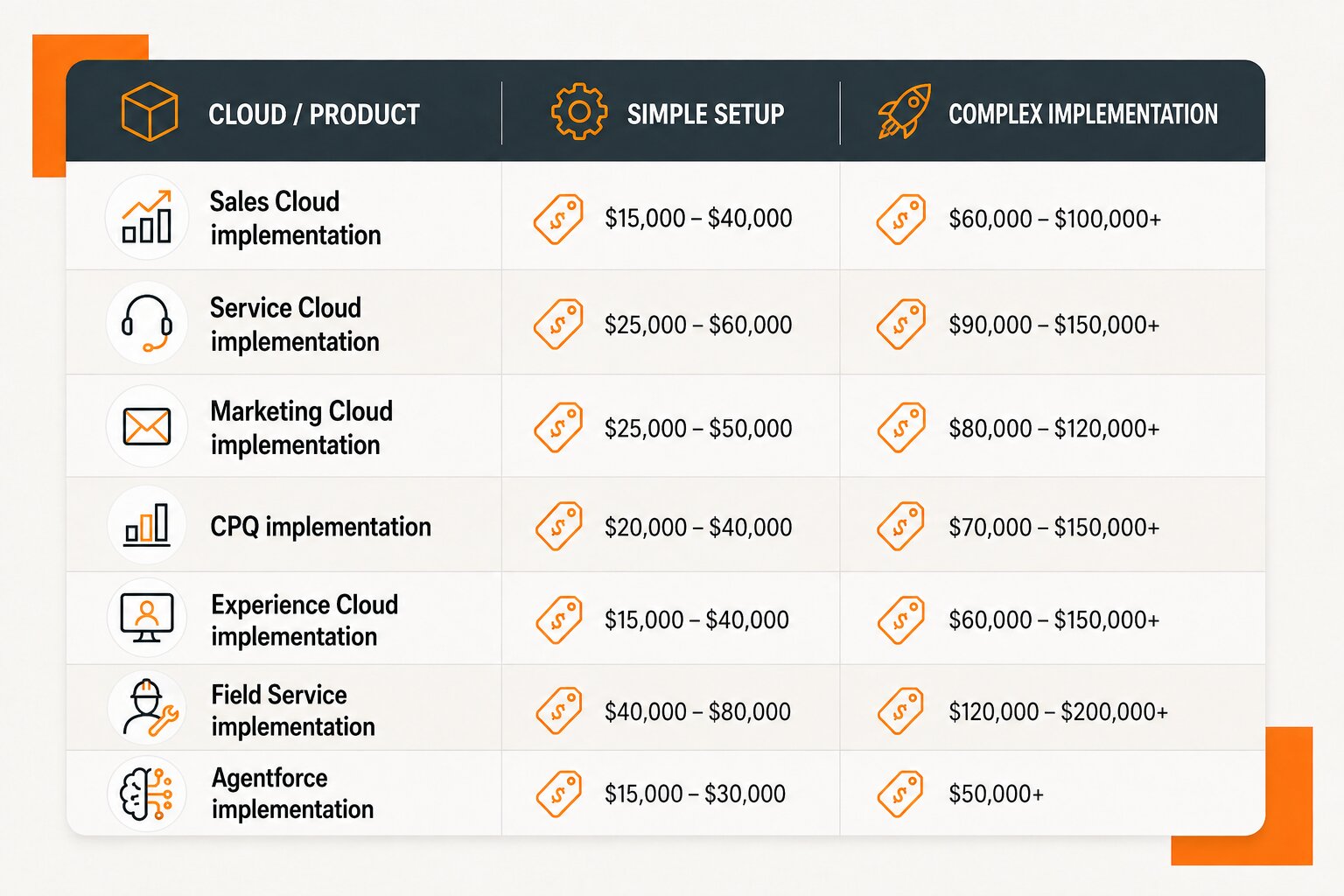

Cost by Product

How Much Does It Cost to Implement Each Salesforce Product?

Sales Cloud is usually the least expensive to implement, starting around $10,000. Products that involve complex data models, pricing logic, or customer-facing experiences, such as Revenue Cloud, Commerce Cloud, Field Service, and Data Cloud, typically start at $30,000–$75,000 and can exceed $200,000.

Salesforce Product Typical Implementation Cost Main Cost Drivers
Sales Cloud
$10,000–$75,000+
Sales process complexity, lead routing, forecasting, integrations
Service Cloud
$15,000–$100,000+
Case routing, Omni-Channel, knowledge base, telephony
Experience Cloud
$20,000–$100,000+
Portal design, authentication, external user permissions
Account Engagement (Pardot)
$10,000–$50,000+
Scoring and grading, forms, B2B nurture programs, CRM sync
Marketing Cloud Engagement
$25,000–$150,000+
Data model, journeys, channels, personalization
Revenue Cloud / CPQ
$30,000–$200,000+
Product catalog, pricing rules, approvals, billing integration
Field Service
$40,000–$200,000+
Scheduling, work orders, mobile setup, inventory
Commerce Cloud
$75,000–$300,000+
Storefront, catalog, checkout, ERP and payment integrations
Agentforce
AI & Data
$20,000–$150,000+
Number of agents and use cases, actions, data access, testing
Data Cloud
AI & Data
$40,000–$200,000+
Data sources, identity resolution, segments, activations
Multi-cloud programs
$75,000–$500,000+
Shared architecture, cross-cloud automation, governance

Ranges cover implementation services only, not licenses or consumption costs. Bars are shown on a $0–$500,000 scale.

Agentforce Implementation Cost

A first Agentforce use case, such as a service agent that answers common questions and escalates complex cases, often falls at the lower end of the range. Costs rise with the number of agents, the actions they perform, and the systems they need to access.

Budget for four things beyond setup:

01

Data readiness

Agents are only as accurate as the data and knowledge they draw from.

02

Actions and automation

The Flows, Apex, and integrations agents trigger.

03

Testing and guardrails

Checking accuracy, escalation paths, and data access.

04

Consumption

Agentforce usage is billed by consumption, so model expected volume before launch.

Data Cloud Implementation Cost

Data Cloud costs depend mainly on how many data sources you connect and how clean they are. Unifying customer profiles across Salesforce, your website, ERP, and marketing platforms requires data mapping, identity resolution rules, and ongoing monitoring.

Like Agentforce, Data Cloud uses consumption-based pricing, so usage planning should be part of the implementation scope.

Why Multi-Cloud Costs More Than the Sum of Its Parts

Sales Cloud+Service Cloud+Experience Cloud≠3 price tags

Implementing these together doesn’t simply add three price tags. Multi-cloud programs need a shared data model, cross-cloud automation, a unified security design, and more integration testing. That extra architecture work is why enterprise multi-cloud budgets often reach several hundred thousand dollars.

AI & Data Projects

Planning an Agentforce or Data Cloud rollout?

Worxwide helps teams scope AI and data projects realistically, from use-case selection to consumption planning.

Talk to an Agentforce Expert →

Cost Factors

What Factors Affect Salesforce Implementation Cost the Most?

Integrations, data migration, and custom development cause the biggest swings in Salesforce implementation cost. Company size, number of users, compliance needs, and timeline pressure also matter, but usually to a lesser degree.

Factor Impact on Cost Why It Matters
Integrations High

●●●
Each connected system needs mapping, error handling, and testing. Custom APIs and middleware add more.
Custom development High

●●●
Apex and custom components take longer to build, test, and maintain than declarative configuration.
Data migration Medium to high

●●●
Multiple source systems, poor data quality, and large historical datasets increase effort.
Number of Salesforce products Medium to high

●●●
Each product adds configuration, and multi-cloud adds architecture work.
Process complexity Medium

●●●
Multiple business units, approval chains, and regional workflows expand scope.
Compliance and security Medium

●●●
Regulated industries need tighter permission models, audit controls, and documentation.
Number of users and locations Medium

●●●
More users mean more training, testing, and change management.
Timeline pressure Medium

●●●
Compressed deadlines often require larger teams working in parallel.

✦ The Practical Takeaway

If you want to control cost, focus on scope.

✓ Use standard Salesforce features before custom code✓ Prioritize the integrations you truly need at launch✓ Clean data before migration

Hidden Costs

Hidden Salesforce Implementation Costs to Budget For

The implementation quote is rarely your full first-year spend. These costs often sit outside the initial proposal.

+$

Data cleanup

Duplicates and inconsistent records must be fixed before migration, and this is often excluded from quotes.

+$

AppExchange apps

Tools for e-signatures, document generation, deduplication, or advanced reporting carry their own subscriptions.

+$

Full sandboxes

Lower editions include limited sandboxes, and full-copy sandboxes for realistic testing cost extra.

+$

Additional data and file storage

Large historical datasets and file volumes can exceed included storage.

+$

Premium support plans

Salesforce’s higher support tiers are typically priced as a percentage of your license spend.

+$

Agentforce and Data Cloud consumption

Usage-based billing grows with volume and needs ongoing monitoring.

+$

Change requests

New fields, workflows, or integrations added mid-project increase effort.

+$

Post-launch administration

Someone needs to manage users, fixes, and enhancements after go-live.

+$

Technical debt

Over-customized or poorly documented builds cost more to maintain and change later.

#1 Cause of Overruns

The Most Common Cause of Overruns: Scope Creep

Sales Cloud + basic data import+ERP integration+New approval flows+Extra dashboards=Well past budget and timeline

A project scoped for Sales Cloud and a basic data import can quickly grow to include an ERP integration, new approval flows, and extra dashboards. Each addition is reasonable on its own, but together they can push a project well past its original budget and timeline.

How to protect your budget:

1

Agree on a clearly documented scope before build starts.

2

Separate must-haves for launch from later-phase enhancements.

3

Ask your partner for change-request rates in writing.

Total Cost of Ownership

What Is the Real First-Year Cost of Salesforce?

Your first-year Salesforce cost is the implementation fee plus licenses, third-party tools, post-launch support, and a contingency reserve. For many companies, implementation turns out to be a smaller share of the total than expected.

First-Year Cost
Licenses+Implementation+Third-Party Tools+Post-Launch Support+Contingency
3-Year TCO
First-Year Cost+2 Years of (Licenses + Tools + Support + Enhancements)

Worked Example: 40-User Company on Sales Cloud Enterprise

Here’s an illustrative budget for a growing B2B company moving to Salesforce with one ERP integration and a CRM data migration. It uses Salesforce list prices before any discounts.

Cost Item Year 1 Year 2 Year 3
Licenses (40 users × $175 × 12 months) $84,000 $84,000 $84,000
Implementation (one-time) $60,000 — —
Contingency (10% of implementation) $6,000 — —
Third-party apps $6,000 $6,000 $6,000
Ongoing support / managed services $36,000 $36,000 $36,000
Enhancements — $15,000 $15,000
Annual total $192,000 $141,000 $141,000
3-year total cost of ownership$474,000
Licenses ~53%Implementation ~13%Support ~23%Enhancements ~6%Apps ~4%Contingency ~1%

What This Example Shows

01

Implementation is only about 13% of the three-year cost

Licenses make up more than half. That’s why choosing the right edition and right-sizing license counts often saves more over time than negotiating a few thousand dollars off the implementation fee.

02

Ongoing costs don’t stop at go-live

Support, enhancements, and new requirements continue every year. Planning for them upfront prevents budget surprises in year two.

03

Architecture choices affect long-term cost

A build that relies heavily on custom code or fragile integrations costs more to support and change later. A simpler design using native Salesforce features keeps years two and three under control.

Your numbers will differ based on edition, user count, discounts, and scope. Factors that typically raise costs over time include:

↑ Adding users or Salesforce products↑ Data storage growth↑ New integrations↑ Annual license price increases↑ AI consumption as Agentforce adoption grows

Free TCO Estimate

Want a TCO estimate built around your actual scope?

Worxwide can model your first-year and three-year Salesforce costs, including licenses, implementation, and support.

Request Your TCO Estimate →

Delivery Models

Who Should Implement Salesforce: Partner, Freelancer, or In-House Team?

For most projects beyond a basic setup, a certified Salesforce implementation partner offers the best balance of cost, speed, and risk. Freelancers work well for small, defined tasks, and in-house teams make sense when you have enough ongoing Salesforce work to justify full-time specialists.

Delivery Model Typical Cost Best For Main Risk
DIY (internal staff, no specialist) Lowest cash cost, high time cost Very small teams using standard features Errors, poor design, and rework later
Freelancer Hourly rates vary widely by region and seniority Small, well-defined tasks Single point of failure, limited range of skills
In-house hire Full-time salary plus benefits, recruitment, and training Continuous, long-term Salesforce work Slow hiring, gaps in specialist skills
Onshore implementation partner Highest hourly rates Strategy-heavy or regulated projects Higher total project cost
Hybrid or offshore partner
Most common fit
Lower blended rates Most implementations, especially build-heavy work Needs clear governance and overlap hours

Salesforce Consulting Rates by Region

Location affects hourly rates, though project scope usually matters more to your final cost.

USA
$125–$200+/hr
UK
$100–$180+/hr
UAE
$80–$175+/hr
India
$25–$75+/hr

Indicative market ranges. Actual rates vary by role, seniority, partner tier, and engagement model. Bars shown on a $0–$200/hr scale.

The answer
No.

Is a Lower Hourly Rate Always Cheaper?

A lower rate only saves money if the team delivers the same quality in a similar number of hours. If a project needs more hours, more rework, or more management from your side, the savings disappear. Compare partners on total project cost and scope, not hourly rate alone.

How a Hybrid Delivery Model Reduces Cost

A hybrid model combines strategic work with your team during your business hours and cost-efficient delivery for build work. In practice, that usually looks like this:

Close collaboration
Discovery, solution architecture, stakeholder workshops, and project governance
⇄ Overlap hours
A few shared hours each day for stand-ups, questions, and reviews
Cost-efficient delivery
Configuration, development, testing, and data migration

Done well, this approach lowers your blended rate without sacrificing quality or communication. The keys are clear documentation, defined overlap hours, and a single accountable project lead.

What About a Mixed Internal and Partner Team?

Internal Salesforce owner
Keeps business knowledge and priorities in-house
+
Partner
Provides architecture, development, and integration expertise

Many companies don’t choose one model exclusively. This setup also makes knowledge transfer easier, so your team is ready to run Salesforce after go-live.

Pricing Models

Fixed-Price vs. Time-and-Materials: Which Pricing Model Is Better?

Fixed-price works best when your scope is clear and stable. Time-and-materials (T&M) works best when requirements are still evolving. Many implementations combine both, using a fixed price for well-defined phases and T&M for enhancements.

Fixed Price

How it works: One agreed price for a defined scope

Best for: Clear, documented requirements
Watch out for: Change requests billed on top

Time and Materials

How it works: You pay for actual hours worked

Best for: Evolving or exploratory scope
Watch out for: Less budget predictability without tight governance

Hybrid

Most common

How it works: Fixed price for core phases, T&M for the rest

Best for: Most mid-size and larger projects
Watch out for: Clear boundaries between fixed and flexible work

Starter Packages

How it works: Pre-defined scope at a set price

Best for: Small teams with standard needs
Watch out for: Limited customization and integrations

When a Starter Package Makes Sense

Many partners, including Worxwide, offer fixed-scope starter packages for teams that need a fast, standard setup. These usually include:

✓ Core Sales Cloud or Service Cloud configuration✓ A set number of users and custom fields✓ A basic data import✓ Introductory training

✓ A good fit if

Your processes are fairly standard. Because the scope is capped, packages typically cost less than a custom project and go live faster.

✕ Choose a scoped project if

You need complex automation, multiple integrations, or large-scale data migration.

Worxwide’s Salesforce starter packages.

See Package Details →

Tips for Choosing a Pricing Model

If you can describe your requirements in detail today→Choose fixed price
If you expect to learn and adjust as the project moves forward→Choose T&M
If part of your scope is clear and part isn’t→Choose hybrid

✦ In every case: ask for assumptions, exclusions, and change-request rates in writing.

Save Money

How Can You Reduce Salesforce Implementation Cost?

The biggest savings come from controlling scope, not from choosing the cheapest partner. Launch with what you need, use standard features first, clean your data early, and plan licenses carefully.

01

Scope

Launch with a minimum viable scope

Separate must-haves for go-live from enhancements that can come later. A phased rollout lowers upfront cost, speeds up launch, and lets real user feedback shape phase two.

02

Build

Use native features before custom code

Check whether a requirement can be met with standard configuration, Flow, or an existing AppExchange app before approving custom development. Less code means lower build cost and lower maintenance cost.

03

Data

Clean your data before migration

Decide what data actually needs to move, then remove duplicates and fix formats beforehand. Migrating clean data is faster and cheaper, and it prevents problems after launch.

04

Scope

Prioritize integrations

Not every system needs to connect on day one. Integrate what’s critical for core processes first, and schedule the rest for later phases.

05

Licensing

Right-size your licenses

Give higher editions or add-ons only to users who need them. Review license usage regularly and remove inactive seats.

06

Licensing

Negotiate your Salesforce contract

Multi-year commitments and larger seat counts often unlock discounts. Timing can help too: Salesforce’s fiscal year ends January 31, and quarter-end periods are often when sales teams are most flexible.

07

Licensing

Check program eligibility

Eligible nonprofits can access donated and discounted licenses through Salesforce’s nonprofit programs, which significantly lowers licensing costs.

08

Scope

Finalize requirements early

Every change during build adds design, development, and testing effort. Agree on workflows, user roles, and reporting needs during discovery.

Where You Shouldn’t Cut Costs

Some savings create bigger costs later. Avoid underfunding:

!

Solution architecture, which shapes how easy Salesforce is to maintain and scale

!

Data validation, because bad data undermines reporting and user trust

!

Security and permissions, especially in regulated industries

!

Testing and UAT, since bugs found after go-live cost more to fix

!

User training, because low adoption makes the whole investment less valuable

✦ The Rule of Thumb

✓ Cut scope
✕ Not quality

A smaller, well-built first release almost always costs less over time than a large release full of low-priority customization.

Quote Checklist

How Do You Compare Salesforce Implementation Quotes?

Compare quotes on what’s included, not just the total price. Line up every proposal against the same checklist, then look closely at assumptions, exclusions, and change-request terms. A cheaper quote that leaves out data cleanup or testing can end up costing more.

Tick each item as you review a proposal:

✓ What to Check Question to Ask the Partner
Scope Which Salesforce products, teams, and processes are included?
Data migration How many records and source systems? Who handles cleanup and validation?
Integrations Which systems are included? Are middleware costs separate?
Customization What’s built with configuration versus custom code?
Testing Are integration testing and UAT support included?
Training Are admin and end-user training included, and for how many users?
Timeline What are the milestones, dependencies, and go-live date?
Post-launch support How long is hypercare, and what does it cover?
Change requests How are out-of-scope requests priced?
Team Who will work on the project, and what are their certifications?

Red Flags in a Salesforce Implementation Quote

⚠ Red Flag

A price without discovery

A detailed fixed quote with no requirements discussion usually means hidden assumptions.

⚠ Red Flag

Vague scope

Lines like “Sales Cloud setup” with no detail on objects, automation, or integrations.

⚠ Red Flag

No exclusions listed

Every honest proposal states what it doesn’t cover.

⚠ Red Flag

Minimal testing time

Complex projects with little time for testing and UAT often slip after launch.

⚠ Red Flag

No post-launch plan

Go-live is when real usage starts, so support should be part of the plan.

Final Check

Before You Sign

Ask the partner to document these in writing, so you can compare quotes on a like-for-like basis and avoid surprises once the project starts:

ScopeAssumptionsExclusionsResponsibilitiesMilestonesAcceptance criteriaChange-request process

Also check relevant experience: the partner’s experience with your Salesforce products, industry, and integration landscape. Relevant experience shortens discovery and helps spot complexity early, which keeps your budget accurate.

Work With Worxwide

Get an Accurate Salesforce Implementation Estimate From Worxwide

Every Salesforce implementation is different, and the most reliable budget starts with a clear scope. Worxwide is a Salesforce Certified Partner with certified consultants across Sales Cloud, Service Cloud, Marketing Cloud, and Agentforce. Since 2016, we have helped 100+ enterprises turn their CRM investments into measurable revenue growth.

2016
Delivering Salesforce since
100+
Enterprises served
Up to 40%
Faster go-live with accelerators
Salesforce Certified Partner
Sales, Service, Marketing, Agentforce

What you get when you work with Worxwide

01

A scoped estimate before you commit

A phase-wise breakdown covering discovery, build, data migration, integrations, testing, go-live, and hypercare.

02

Clear assumptions and exclusions

So there are no surprises mid-project.

03

Strategy-first delivery

Fixes integration and adoption gaps before they stall your investment.

04

Proven accelerator frameworks

Help get your org live up to 40% faster.

05

Multi-cloud expertise

Across Sales Cloud, Service Cloud, Marketing Cloud, and AI-led Agentforce.

06

Post-go-live support

Through Salesforce staffing and managed services, with dedicated or embedded consultants, admins, and developers.

Client proof

Global optical manufacturing brand
60%
faster sales cycle
70%
reduction in errors

Through a Salesforce-led digital transformation.

Leading publishing company
65%
faster lead response

Unified sales and distribution on Salesforce.

Whether you’re:

Launching Salesforce for the first timeMigrating from another CRMAdding new clouds

We’ll help you understand what your project should cost and why.

Ready to plan your budget?
